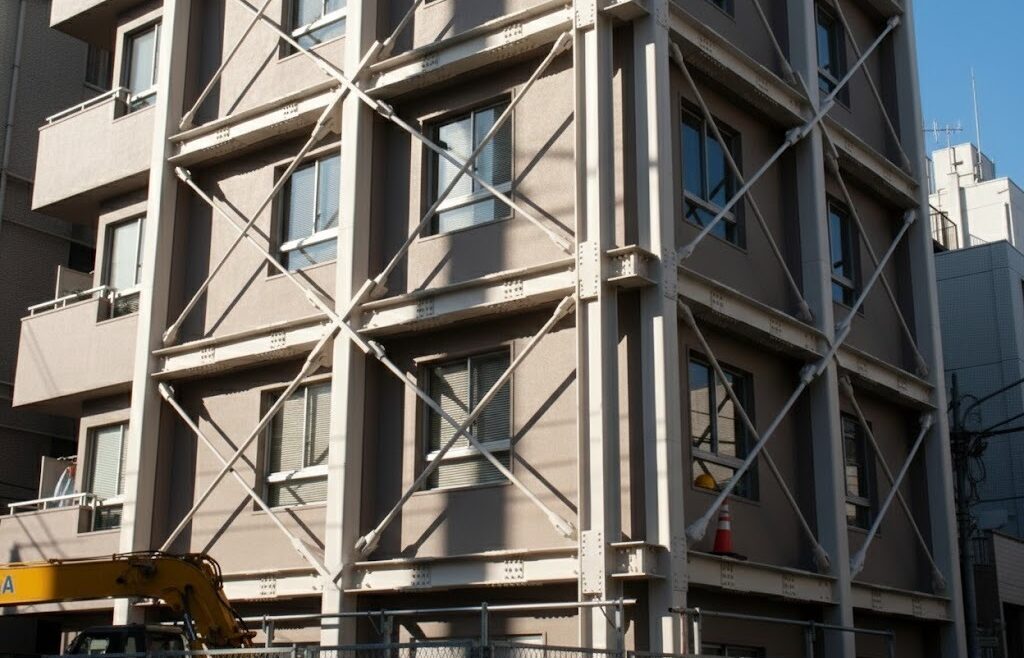

seismic retrofitting Los Angeles

Seismic Retrofitting Los Angeles: Protect Your Building

Seismic Retrofitting Los Angeles: Protect Your Building 1024 683 Cecille Maristela

LA’s Seismic Reality: Why Retrofitting Isn’t Optional

Los Angeles sits on multiple active fault lines. The “Big One”—a magnitude 7.8+ earthquake on the San Andreas Fault—has a 46% probability of occurring within the next 30 years according to USGS data. For commercial property owners, this isn’t distant speculation. It’s immediate financial exposure.

Seismic retrofitting Los Angeles projects address this vulnerability by strengthening buildings to withstand earthquake forces. The alternative is catastrophic: structural collapse, tenant injuries, litigation exposure, and total asset loss. Buildings constructed before 1977 face particularly high risk, as they predate modern seismic code requirements for earthquake commercial buildings.

Substrata brings structural engineering expertise to seismic retrofitting Los Angeles. Our focus is practical: preventing collapse, protecting occupants, and preserving commercial asset value through proven structural strengthening techniques.


commercial construction cost per square foot LA

Code Evolution: Current Requirements You Can’t Ignore

Los Angeles County introduced ordinances in 2025 mandating seismic retrofit of high-rise nonductile concrete buildings, requiring structural evaluations and retrofits within 20 years of compliance orders. This represents the latest evolution in increasingly strict seismic safety requirements.

Mandatory Retrofit Ordinances

The city of Los Angeles requires wood-frame soft-story building retrofits, with compliance reports showing thousands of buildings under evaluation as of 2024. These ordinances target specific vulnerable building types:

Soft-Story Buildings: Wood-frame structures with weak first floors (typically parking areas). Ordinance 183893 requires these buildings to submit structural analysis within two years and complete retrofits on phased timelines.

Non-Ductile Concrete Buildings: Structures with concrete floors and roofs built before January 13, 1977 must undergo evaluation and retrofit, with 25-year completion timelines from compliance orders. These buildings demonstrated catastrophic failure patterns in past earthquakes.

Unreinforced Masonry Buildings (URMs): Brick structures without steel reinforcement. While most URM retrofits should be complete under 1986 legislation, enforcement continues in seismic retrofitting Los Angeles.

Financial Penalties for Non-Compliance

Property owners ignoring these ordinances face escalating consequences:

  • Inability to obtain building permits for other work
  • Required disclosure to tenants about seismic vulnerability
  • Potential condemnation and forced vacancy
  • Civil liability for injuries during earthquakes
  • Reduced property values and financing difficulties

Substrata advises clients to address seismic retrofitting Los Angeles requirements proactively. Reactive compliance after receiving official orders provides less flexibility in scheduling and budgeting for structural strengthening.


Common Retrofit Techniques: Engineering Solutions

Seismic retrofitting Los Angeles employs several proven structural strengthening approaches. The appropriate technique depends on building type, construction materials, and specific vulnerabilities.

Shear Walls

Shear walls resist lateral forces during earthquakes. These reinforced walls are designed to absorb and distribute lateral movement, with commercial buildings often benefiting from added shear support.

Installation involves:

  • Structural analysis identifying optimal wall locations
  • Foundation reinforcement to anchor new shear walls
  • Steel or concrete construction depending on building type
  • Integration with existing structural systems

Shear walls work effectively in buildings with sufficient floor-to-ceiling height and adequate foundation capacity. Cost ranges from $150-300 per linear foot depending on height and materials for earthquake commercial buildings.

Moment Frames

Steel moment frames provide lateral resistance through rigid beam-column connections. Unlike shear walls, moment frames don’t require solid surfaces—allowing preservation of windows and open floor plans in seismic retrofitting Los Angeles projects.

Moment frame characteristics:

  • Welded or bolted connections creating rigid joints
  • Ability to accommodate architectural features
  • Higher material costs than shear walls ($250-450 per linear foot)
  • Complex installation requiring specialized welding expertise

Substrata evaluates whether moment frames or shear walls provide superior cost-effectiveness for specific structural strengthening requirements.

Base Isolation Systems

Base isolation involves separating the building structure from ground motion by installing bearings or shock absorbers that absorb seismic energy. This advanced technique provides superior protection but carries substantial costs.

Base isolation implementation:

  • Building must be temporarily lifted to install isolators
  • New foundation systems required to accommodate bearings
  • Costs typically $50-150 per square foot for entire building
  • Most cost-effective for essential facilities requiring post-earthquake functionality

Base isolation systems represent premium solutions in seismic retrofitting Los Angeles. Hospitals, data centers, and critical infrastructure justify these investments. Standard commercial buildings rarely achieve positive cost-benefit ratios with base isolation.

Roof and Wall Anchoring

Older buildings often lack secure roof-to-wall connections, creating risk of roof detachment during earthquakes. Retrofitting with steel anchors and continuity ties strengthens these connections.

This represents the most common and cost-effective structural strengthening for earthquake commercial buildings:

  • Steel anchors bolted through walls into roof framing
  • Continuity ties connecting opposite walls
  • Costs ranging $15,000-75,000 for typical commercial buildings
  • Minimal operational disruption during installation

Substrata frequently recommends roof anchoring as first-priority seismic retrofitting Los Angeles work, as it prevents the most catastrophic failure mode at reasonable cost.


adaptive reuse

Assessing Your Building: When Retrofitting Is Necessary

Not every building requires immediate seismic retrofitting Los Angeles work. Strategic assessment determines actual risk and appropriate response.

Triggering Factors for Evaluation

Building owners should conduct seismic evaluations when:

  • Structure was built before 1977 (pre-modern seismic codes)
  • Building received official compliance orders from city/county
  • Planned major renovations exceed 50% of building value
  • Insurance carriers require seismic certification
  • Tenant concerns about earthquake commercial buildings safety emerge
  • Property sale or refinancing requires seismic disclosure

Professional Structural Assessment

Licensed structural engineers conduct seismic evaluations examining:

Foundation Condition: Soil type, foundation depth, existing damage, and capacity to resist lateral loads during structural strengthening.

Structural System: Load path continuity, lateral force resisting elements, connection adequacy, and system redundancy.

Material Condition: Concrete strength, steel corrosion, wood deterioration, and masonry integrity affecting seismic retrofitting Los Angeles feasibility.

Building Irregularities: Soft stories, plan discontinuities, vertical irregularities, and torsional vulnerabilities in earthquake commercial buildings.

Assessment reports quantify structural deficiencies and recommend specific remediation. Substrata provides these evaluations establishing the technical basis for structural strengthening decisions.

Risk-Based Prioritization

Not all deficiencies require immediate correction. Risk-based analysis considers:

  • Probability of major earthquake during remaining building life
  • Occupancy type and density (life safety exposure)
  • Building importance (essential vs. standard occupancy)
  • Financial capacity and timing constraints

Buildings housing high-density occupancies (schools, hospitals, theaters) justify more aggressive seismic retrofitting Los Angeles timelines than low-occupancy warehouses, even with similar structural deficiencies.


adaptive reuse

Cost-Benefit Analysis: Protection vs. Investment

Seismic retrofitting Los Angeles projects require substantial capital investment. Rational decision-making demands honest cost-benefit analysis comparing protection value against expenditure.

Typical Retrofit Costs

Structural strengthening costs vary dramatically based on building type and deficiency severity:

Soft-Story Buildings: $50,000-200,000 for typical 20-50 unit apartment buildings. Cost depends on number of required shear walls and foundation work.

Non-Ductile Concrete: $75-150 per square foot for comprehensive retrofit of earthquake commercial buildings. A 50,000-square-foot building might require $3.75M-7.5M investment.

Roof Anchoring Only: $15,000-75,000 for commercial buildings under 20,000 square feet.

Base Isolation: $50-150 per square foot affecting entire building footprint.

These figures represent construction costs only. Add 15-25% for engineering, permitting, and project management in seismic retrofitting Los Angeles.

Financial Benefits of Retrofitting

Quantifying retrofit benefits requires examining multiple value categories:

Avoided Damage Costs: A magnitude 7.0 earthquake causes average damage of 40-60% of building value for unreinforced structures. For a $10M building, potential avoided damage is $4M-6M. Seismic retrofitting Los Angeles typically reduces this damage to 10-20% of building value.

Business Interruption Reduction: Post-earthquake building closures for repairs average 6-18 months for non-retrofitted earthquake commercial buildings. Retrofitted buildings often resume occupancy within weeks. For commercial properties generating $500,000 annual NOI, avoided interruption is worth $250,000-750,000.

Insurance Premium Reduction: Some carriers offer 10-25% premium reductions for certified seismic retrofitting. On annual premiums of $100,000, this yields $10,000-25,000 annual savings.

Asset Value Preservation: Buildings with certified structural strengthening command higher sale prices and better financing terms. Market studies show 5-15% value premiums for retrofitted properties.

Break-Even Analysis

Consider a 40,000-square-foot commercial building requiring $2.5M seismic retrofitting Los Angeles investment:

Annual benefit: $35,000 (insurance savings) + $75,000 (avoided risk-adjusted damage) = $110,000

Simple payback: 22.7 years

This payback exceeds typical holding periods for many investors. However, analysis changes when considering:

  • Mandatory compliance making retrofit unavoidable
  • Tenant retention and attraction advantages
  • Litigation risk from earthquake injuries
  • Refinancing requirements and sale constraints

Substrata helps clients develop realistic financial models for structural strengthening decisions specific to their properties and objectives.


Proactive Protection for Commercial Assets

Seismic retrofitting Los Angeles protects against low-probability, high-consequence events. The 46% probability of major earthquake in 30 years means 54% probability of NOT experiencing one. This creates decision complexity for earthquake commercial buildings owners.

The rational approach considers:

  • Mandatory compliance requirements eliminating decision discretion
  • Occupant life safety obligations transcending pure financial analysis
  • Asset protection justifying reasonable structural strengthening investment
  • Competitive positioning in quality-conscious tenant markets

Substrata brings structural engineering expertise to seismic retrofitting Los Angeles. We evaluate buildings honestly, recommend appropriate interventions, and execute structural strengthening that balances protection with investment efficiency.

Buildings that survive the next major earthquake will command premium values. Those that don’t will represent total losses. The question isn’t whether seismic retrofitting makes sense—it’s which techniques provide optimal protection for your specific circumstances.

Ready to assess your building’s seismic vulnerability? Contact Substrata to discuss structural evaluation, code compliance requirements, and cost-effective structural strengthening strategies protecting your commercial real estate investment.

The Art of Adaptive Reuse: Transforming LA’s Historic Buildings for Modern Use

The Art of Adaptive Reuse: Transforming LA’s Historic Buildings for Modern Use 1600 1200 Cecille Maristela

The Value of Preserving LA’s Architectural Heritage

Los Angeles loses 20% of its pre-1940s buildings every decade. That’s not preservation failure—it’s economic reality. Most old buildings get demolished because owners can’t justify renovation costs.

Adaptive reuse Los Angeles projects reverse this equation when executed properly. The data shows historic building renovation costs 10-30% less than new construction while retaining 75-90% of embodied carbon. For developers considering commercial conversion projects, this means faster market entry at lower capital requirements.

Substrata specializes in adaptive reuse transforming Los Angeles landmarks into productive commercial space. The business case for preservation construction isn’t sentimental—it’s financial. Buildings with the right characteristics in strong locations deliver superior returns compared to ground-up development.


commercial construction cost per square foot LA

Identifying Candidates: What Makes a Building Suitable

Not every old building deserves adaptive reuse. Assessment requires honest evaluation of structural integrity, location economics, and market viability for historic building renovation.

Structural Assessment Criteria

Foundation condition determines everything in preservation construction. Buildings with compromised foundations require investment exceeding 40% of total costs. Substrata evaluates concrete carbonation, steel corrosion, and soil stability before recommending adaptive reuse Los Angeles projects. If foundation repair exceeds new construction costs, demolition is the rational choice.

Load-bearing capacity matters for commercial conversion projects. Former industrial buildings often support heavier loads than modern office use requires—a significant advantage. Residential-to-commercial conversions face the opposite problem: floors designed for 40 PSF won’t support office requirements of 50-100 PSF without substantial reinforcement.

Ideal candidates for historic building renovation have:

  • Foundations requiring less than 15% of budget for remediation
  • Clear structural bay systems adaptable to modern layouts
  • Roof systems with minimum 20-year remaining lifespan
  • Exterior envelope requiring less than 25% replacement
  • Floor-to-ceiling heights of 12+ feet supporting contemporary uses

Location and Market Viability

Downtown Los Angeles, Arts District, and Culver City offer the strongest markets for adaptive reuse Los Angeles projects. These areas combine zoning flexibility with tenant demand supporting premium rents that justify preservation construction costs.

The Adaptive Reuse Ordinance (ARO) in Downtown LA allows residential conversion of pre-1974 commercial buildings with reduced parking requirements. This policy change generated over $2 billion in private investment since 1999, according to the Los Angeles Conservancy. Buildings outside ARO zones face standard code compliance, eliminating much of the cost advantage.

Substrata analyzes location economics before recommending historic building renovation. A structurally sound building in a weak market doesn’t justify investment regardless of architectural merit.


value engineering commercial construction

Challenges and Solutions: Code Compliance and Structural Upgrades

Modern building codes weren’t written for 1920s warehouses. The gap between historic construction methods and current requirements creates the primary expense in commercial conversion projects.

Seismic Upgrades: Non-Negotiable Requirements

Los Angeles operates in a high seismic zone. Unreinforced masonry buildings require comprehensive retrofitting costing $25-60 per square foot in typical adaptive reuse Los Angeles projects:

  • Steel moment frames or shear walls
  • Foundation anchoring systems
  • Diaphragm strengthening at floor and roof levels
  • Parapet bracing or removal

Seismic upgrades typically represent 25-35% of total budgets in adaptive reuse Los Angeles projects. While this investment appears substantial, it preserves buildings capable of generating rental income that justifies the expenditure. That’s the preservation construction trade-off: higher upfront costs, superior long-term returns.

Accessibility Compliance Solutions

ADA requirements apply to all commercial conversion projects. Historic buildings rarely have compliant restrooms, entries, or circulation paths. Budget 8-12% of construction costs for accessibility upgrades in historic building renovation:

  • Elevator installation (if none exists)
  • Accessible restroom retrofits
  • Ramp construction and door hardware replacement
  • Tactile warning systems and signage

California’s disabled access requirements exceed federal ADA standards. Substrata coordinates accessibility solutions that meet code while respecting historic character—finding creative approaches that satisfy both requirements.

Fire Life Safety Systems

Fire suppression requirements vary by occupancy type and building size. Converting warehouses to creative office use triggers sprinkler requirements that didn’t exist under industrial occupancy.

Substrata allocates 6-10% of budgets for life safety systems in adaptive reuse Los Angeles projects:

  • Automatic fire sprinkler installation
  • Fire alarm and emergency lighting systems
  • Exit corridor improvements and egress upgrades
  • Fire-rated assemblies at required separations

Substrata uses California Historical Building Code provisions to reduce compliance costs while maintaining safety standards in historic building renovation projects.


adaptive reuse

Financial Incentives: Tax Credits and Grants Available

Tax credits and grants improve the economics of commercial conversion projects. Understanding which incentives deliver actual value versus administrative burden determines whether to pursue them.

Federal Historic Rehabilitation Tax Credit

This 20% credit applies to certified historic structures undergoing substantial rehabilitation in adaptive reuse Los Angeles projects. Requirements:

  • Building must be listed on National Register or contribute to registered historic district
  • Rehabilitation costs must exceed adjusted building basis or $5,000
  • Work must meet Secretary of Interior’s Standards for Rehabilitation

Application takes 6-12 months and requires architectural documentation proving preservation standards compliance. For projects over $5M, the credit typically justifies administrative costs. Smaller historic building renovation projects often find paperwork burden exceeds benefit.

Mills Act Property Tax Reduction

Property owners achieve 40-60% property tax reductions through Mills Act contracts with local jurisdictions. The property must be historically significant, and owners commit to maintaining historic character for 10+ years.

For a building with $8M assessed value in Los Angeles County, Mills Act participation saves approximately $64,000 annually—$640,000 over the contract term. That’s real money improving returns on adaptive reuse Los Angeles investments.

State and Local Grant Programs

California offers additional incentives for preservation construction:

  • California Cultural and Historical Endowment grants (up to $5M)
  • State Historic Rehabilitation Tax Credit (20% of qualified expenses)
  • Local redevelopment agency funding in designated areas

Projects combining multiple incentives can achieve effective cost reductions of 30-40%.


adaptive reuse

Sustainability Benefits of Reuse vs. New Construction

The greenest building is the one already standing. This isn’t environmental rhetoric—it’s carbon accounting demonstrating why adaptive reuse Los Angeles projects deliver superior sustainability outcomes.

Embodied Carbon Comparison

New construction generates 500-700 kg CO2 equivalent per square meter from materials production, transportation, and installation. Commercial conversion projects retain 75-90% of existing materials, reducing embodied carbon by 300-500 kg CO2/m².

For a 50,000-square-foot building, historic building renovation represents approximately 1,400-2,300 metric tons of avoided carbon emissions—equivalent to removing 300 cars from roads for one year. That environmental benefit comes free with preservation construction cost savings.

Construction Waste Elimination

Demolition sends 90-95% of building materials to landfills. Adaptive reuse Los Angeles projects divert this waste stream entirely. A typical warehouse demolition generates 15-20 tons of waste per 1,000 square feet. Preservation construction eliminates this environmental impact while reducing disposal costs of $50-80 per ton.

Over a 50,000-square-foot project, waste elimination saves $37,500-60,000 in disposal fees while preventing 750-1,000 tons of material from reaching landfills.

Operational Energy Performance

Historic buildings weren’t designed for energy efficiency, creating legitimate performance concerns. However, modern MEP systems and envelope improvements bring these structures to current standards in commercial conversion projects.

Adaptive reuse Los Angeles projects can achieve LEED certification through:

  • High-efficiency HVAC systems replacing outdated equipment
  • Advanced envelope sealing and insulation upgrades
  • LED lighting and daylight harvesting from historic windows
  • Water-efficient fixtures and greywater systems where applicable

With proper upgrades, historic building renovation can match or exceed modern efficiency standards.

Material Reuse Value

Preservation construction retains materials impossible to replicate economically:

  • Old-growth timber framing with superior structural properties
  • Full-dimension lumber unavailable in modern markets
  • Brick masonry with character and patina requiring decades to develop
  • Concrete with strength characteristics matching or exceeding contemporary mixes

These materials carry both functional and aesthetic value that new construction cannot reproduce at any cost.


Conclusion: Blending History with Modernity

Adaptive reuse Los Angeles projects succeed by respecting architectural heritage while meeting contemporary performance requirements. The buildings that survive aren’t museum pieces—they’re productive commercial assets generating competitive returns.

Substrata brings specialized preservation construction capabilities to historic building renovation. Our approach combines structural engineering expertise, code compliance knowledge, and realistic budgeting for commercial conversion projects.

The economics favor adaptive reuse. The environmental case is clear. The cultural benefit is undeniable. For owners with suitable buildings in strong locations, these projects represent compelling development opportunities.

Ready to evaluate your building’s adaptive reuse potential? Contact Substrata to discuss structural assessment, code compliance strategies, and financial feasibility for transforming your historic property into productive commercial space.

A Toast to 2026: Designing the Ultimate Home Bar & Beverage Station

A Toast to 2026: Designing the Ultimate Home Bar & Beverage Station 1920 1280 Cecille Maristela

Moving the Bar Out of the Kitchen Corner

The home bar design has evolved from afterthought to architectural statement. No longer relegated to kitchen corners or basement rec rooms, today’s wet bar construction creates destinations—spaces where hosts craft cocktails with theatrical flair while guests gather in anticipation of New Year’s toasts and celebrations throughout the year.

This transformation reflects how we entertain. Formal dining rooms see less use while casual gathering spaces thrive. The beverage center becomes social focal point—where conversations flow as freely as drinks, where mixology becomes performance art, and where thoughtful home bar design elevates ordinary evenings into memorable occasions.

At Substrata, we’ve designed countless entertaining stations recognizing that superior wet bar construction requires more than adding a sink and refrigerator. Great home bar design integrates architecture, infrastructure, materials, and custom cabinetry creating spaces that function beautifully while reflecting owners’ entertaining styles. As we raise glasses to 2026, this guide explores how to design ultimate home bars worthy of your best celebrations.


Location, Location, Location: Strategic Positioning

Connecting to Main Gathering Spaces

Successful home bar design begins with location analysis. The beverage center must be accessible from primary entertaining areas while maintaining defined identity separate from kitchen proper.

Ideal Location Characteristics:

Visual Connection to Living Areas: Position wet bar construction where bartenders maintain eye contact with guests in living rooms or family rooms. This connectivity enables hosts to mix drinks while remaining socially engaged—unlike kitchen isolation where hosts disappear during cocktail preparation.

Acoustic Separation from Kitchens: While visual connection matters, acoustic separation proves equally important. Home bar design works best when ice shaking, blender noise, and glass clinking don’t overwhelm kitchen conversations during meal preparation. Strategic walls or partial barriers provide sound control.

Circulation Flow: Entertaining station placement should facilitate natural traffic patterns—not blocking primary circulation routes but creating destinations encouraging gathering. Alcoves off main spaces, dedicated rooms adjacent to living areas, or peninsula configurations extending from walls all work effectively.

Proximity to Outdoor Spaces: For homes with patios or decks, wet bar construction near exterior doors creates seamless indoor-outdoor entertaining. Guests access beverages easily when transitioning between spaces—essential for year-round California entertaining.

Creating Defined Boundaries

While connectivity matters, distinguished home bar design requires clear spatial definition transforming bars from kitchen appliances into destinations.

Boundary-Defining Strategies:

Architectural Elements: Archways, columns, or dropped soffits signal transition from general space to beverage center. These elements frame wet bar construction without closing it off completely—maintaining openness while establishing identity.

Material Changes: Distinct backsplash materials, countertop selections, or flooring transitions visually separate entertaining station from surrounding spaces. Marble or quartzite bar tops contrasting with kitchen granite clearly differentiate zones.

Lighting Definition: Dedicated lighting—pendant fixtures over bars, under-cabinet accent lighting, or decorative sconces—establishes home bar design as intentional feature rather than kitchen overflow. Light draws attention and defines boundaries through illumination rather than walls.

Furniture Placement: Bar stools or counter-height seating naturally defines beverage center zones. Even without physical barriers, seating arrangement signals “this is the bar”—guests understand where to gather for drinks.


The Build-Out: Infrastructure and Materials

Essential Plumbing for Wet Bar Construction

True wet bar construction requires plumbing infrastructure supporting full beverage service functionality. Dry bars with only refrigeration limit mixology capabilities severely.

Plumbing Requirements:

Bar Sink Installation: Minimum 15″x15″ undermount sink, ideally 18″x18″, provides adequate space for rinsing glassware and washing bar tools. Smaller prep sinks prove frustrating—limiting functionality wet bar construction should provide. Depth of 6-8 inches balances utility without excessive protrusion beneath counters.

Hot and Cold Water Supply: Both supplies enable proper glassware cleaning and tea/coffee preparation. Single-temperature water limits entertaining station versatility. Shutoff valves beneath sinks facilitate future maintenance without whole-house water shutdown.

Waste and Vent Lines: Proper drainage with venting prevents slow drains and odors undermining home bar design ambiance. Building codes require venting—shortcuts create problems necessitating expensive later corrections.

Drain Placement Considerations: For wet bar construction in upper floors or locations distant from main plumbing stacks, drain routing requires careful planning. Concrete slabs, structural beams, and finished ceilings below complicate plumbing runs—early design integration prevents costly compromises.

Under-Counter Refrigeration

Dedicated refrigeration distinguishes serious home bar design from token gestures. Accessing kitchen refrigerators during entertaining disrupts flow—beverage center self-sufficiency enables seamless service.

Refrigeration Options:

Beverage Refrigerators: Glass-door units (24″ or 30″ wide) hold 100-150 cans/bottles in visible, organized display. For wet bar construction focused on beer, wine, and mixers, beverage refrigerators prove ideal. Temperature ranges of 33-50°F accommodate various beverage types.

Wine Refrigerators: Dual-zone wine coolers maintain separate temperatures for red (55-60°F) and white wines (45-50°F). For entertaining station serving primarily wine, dedicated wine refrigeration with proper humidity control protects investment collections.

Combination Units: Some manufacturers offer split-zone refrigeration—beverage storage on one side, wine storage on the other. These maximize home bar design flexibility in limited space.

Ice Makers: Built-in ice makers (15″ wide typical) produce 25-50 pounds daily—adequate for serious entertaining. Clear ice makers creating restaurant-quality cubes elevate wet bar construction significantly. While expensive ($2,000-$4,000), ice quality impacts drink presentation dramatically.

Undercounter vs. Freestanding: True built-in undercounter refrigeration integrates seamlessly into custom cabinetry. Freestanding units adapted for built-in use often lack proper ventilation—creating performance issues and premature failure in home bar design applications.

Durable Surface Materials

Entertaining station surfaces endure spills, citrus acids, alcohol exposure, and impact from glassware. Material selection determines whether wet bar construction maintains appearance or deteriorates into shabby disappointment.

Optimal Counter Surface Materials:

Quartzite (Natural Stone): Combines marble-like aesthetics with granite-like durability. Harder than granite, quartzite resists scratching, staining, and etching from acidic cocktail ingredients. While requiring sealing, quartzite handles bar abuse better than marble’s beauty suggests.

Engineered Quartz: Non-porous surface resists staining absolutely—no sealing required. While heat tolerance proves lower than natural stone, quartz’s maintenance-free nature suits home bar design perfectly. Broad color and pattern selection enables design flexibility.

Stainless Steel: Professional bar aesthetic with ultimate durability. Stainless resists everything—heat, stains, acids, impacts. However, fingerprints show prominently and softer finishes scratch visibly. For industrial-style wet bar construction, stainless creates authentic commercial appearance.

Butcher Block: Wood provides warmth and traditional bar character. Modern wood counters receive multiple oil or urethane coats creating serviceable surfaces. However, wood requires more maintenance than stone—not ideal for primary bar counters but excellent for back-bar cabinetry tops.

Backsplash Considerations: Backsplashes behind entertaining station require the same durability as counters—plus design impact. Large-format stone slabs, decorative tile mosaics, or mirrored surfaces all work effectively. Height of 18-24 inches protects walls adequately while providing design canvas.


Style & Storage: Custom Cabinetry Solutions

Glassware Storage and Display

Properly designed custom cabinetry transforms wet bar construction from functional necessity into displayed art—showcasing glassware collections while enabling efficient service.

Glassware Cabinet Strategies:

Glass-Front Upper Cabinets: Displaying glassware behind glass doors protects from dust while showcasing collections. Interior cabinet lighting illuminates glassware creating jewelry-box effect elevating home bar design drama. Standard 12″ deep upper cabinets accommodate most glassware, while 15″ depth suits oversized pieces.

Stemware Racks: Under-cabinet stemware holders suspend wine glasses by their bases—saving shelf space while displaying stems elegantly. Racks accommodate glasses with 6-8″ tall bowls—standard wine glass dimensions. For wet bar construction emphasizing wine service, stemware racks prove essential.

Open Shelving Display: Floating shelves or bracket-supported displays create lighter aesthetic than solid cabinetry. For entertaining station in open floor plans, open shelving prevents visual bulk while displaying favorite pieces. Depth of 10-12 inches accommodates typical barware.

Pull-Out Shelving: Deep lower cabinets benefit from pull-out shelves enabling access to items at cabinet backs. For home bar design storing large serving pieces or small appliances, pull-outs prevent forgotten items lost in dark corners.

Wine Storage Integration

Serious wine collections require proper storage conditions—temperature control, humidity, and protection from light and vibration. Custom cabinetry should integrate wine storage meeting collection preservation needs.

Wine Storage Options:

Built-In Wine Racks: X-pattern or honeycomb racks hold individual bottles in custom cabinetry. For daily-drinking wines, room-temperature storage in decorative racks proves adequate. Standard wine bottle dimensions require openings approximately 3.75″ diameter—accounting for capsule and bottle variations.

Wine Refrigerator Integration: As discussed in refrigeration section, dedicated wine coolers maintain proper temperatures. Custom cabinetry should accommodate wine refrigerator dimensions with proper ventilation clearances—typically 1″ on sides and 3″ at back for undercounter models.

Display and Storage Balance: Most collections benefit from both display (favorite bottles, special occasions) and hidden storage (everyday bottles, backstock). Wet bar construction should include visible wine racks showcasing 12-24 special bottles plus concealed storage for additional inventory.

Spirits Organization

Liquor bottles require different storage than wine—upright positioning, easy access, and attractive display encouraging experimentation with various spirits in home bar design.

Spirits Storage Solutions:

Tiered Shelving: Stair-stepped or stadium-style shelving displays spirits with labels visible—enabling quick selection and creating visual interest. Depths of 8-10 inches accommodate most liquor bottles while tiers lift back rows into view.

Mirrored Back Walls: Mirrors behind spirits shelving reflect bottles creating appearance of doubled collections while adding depth and light to wet bar construction. This classic technique creates sophisticated entertaining station ambiance.

Lazy Susan Cabinets: Rotating shelves in corner cabinets provide efficient spirits storage in otherwise awkward spaces. For home bar design in space-constrained locations, corner optimization becomes essential.

Security Considerations: Families with children should consider locking cabinets for spirits storage. Modern cabinet locks operate discreetly—maintaining aesthetics while providing responsible security in wet bar construction.


The Finishing Touches: Details Creating Distinction

Bar Seating That Invites Lingering

Comfortable seating transforms beverage center from service station into destination. Bar stool selection impacts how long guests remain engaged with bartenders.

Seating Design Considerations:

Counter Height Standards: Bar counters at 42″ height require 30″ counter-height stools (seat height). Standard 36″ counter height uses 24″ counter-height stools. Proper proportion ensures comfortable seating without awkward leg positioning.

Backrest Importance: Backless stools suit quick service but discourage extended sitting. For home bar design encouraging conversation, stools with backs prove more hospitable. Swivel mechanisms add convenience enabling guests to shift attention between bartender and living room conversations.

Footrest Integration: Built-in footrests on cabinetry or stool-integrated footrests provide comfort essential for extended sitting. Without footrests, dangling feet become uncomfortable quickly—limiting entertaining station seating duration.

Quantity Calculation: Allow 24-30″ width per stool—enabling comfortable spacing without crowding. For 6-foot bar counter, 2-3 stools maximum. Overcrowding destroys comfort wet bar construction should provide.

Lighting Creating Ambiance

Lighting design makes or breaks home bar design ambiance. Harsh overhead fixtures create clinical atmosphere while layered lighting creates warmth inviting gathering.

Multi-Layer Lighting Strategy:

Task Lighting: Under-cabinet LED strips illuminate work surfaces where drinks mix—providing adequate light for precise bartending. Color temperature of 2700-3000K creates warm glow without harsh blue tones.

Accent Lighting: Interior cabinet lighting showcases glassware and bottles transforming storage into display. LED puck lights or linear strips with dimming capability enable ambiance adjustments for entertaining station throughout evenings.

Pendant Fixtures: Statement pendants over bar counters establish wet bar construction as intentional design feature. Height of 30-36″ above counter provides illumination without obstructing sightlines. Multiple small pendants often work better than single large fixture.

Backlighting: LED strips behind translucent stone backsplashes or shelving create dramatic glow effects. For home bar design making bold statements, backlighting adds sophistication and drama.

Dimming Control: All lighting should dim—enabling adjustment from bright daytime cocktail mixing to soft evening ambiance. Scene-setting capabilities transform entertaining station atmosphere matching party progression.

Incorporating Display Elements

Final home bar design layer involves display—whether entertainment screens, artwork, or architectural details completing the space.

Display Integration Options:

Television Mounting: For wet bar construction doubling as sports-watching headquarters, TV placement above or adjacent to bar enables viewing while mixing drinks. Screen size should relate to viewing distance—55-65″ screens suit typical 8-10 foot viewing distances.

Artwork Display: For sophisticated entertaining station aesthetic, artwork above bars creates visual interest without electronic distraction. Beverage-themed art, abstracts, or photography all work effectively. Lighting artwork separately adds gallery-quality presentation.

Mirror Installations: Large mirrors create depth while reflecting light throughout space. Antiqued or decorative mirrors add character that plain glass lacks—contributing to wet bar construction personality.

Architectural Details: Crown molding, decorative columns, or paneled pilasters add traditional elegance to home bar design. These details distinguish custom wet bar construction from generic installations.


Conclusion: Toasting to Thoughtful Design

As we raise glasses to 2026, the ultimate home bar design represents more than functional beverage preparation—it’s the backdrop for connection, celebration, and memory-making. Whether hosting New Year’s Eve celebrations, casual weekend gatherings, or quiet cocktail hours for two, well-designed wet bar construction elevates every occasion.

The transformation from kitchen corner afterthought to architectural destination requires thoughtful planning—strategic location connecting to gathering spaces while maintaining identity, infrastructure supporting full wet bar construction functionality, durable materials withstanding entertaining abuse, custom cabinetry displaying and organizing collections, and finishing details creating ambiance worthy of finest occasions.

At Substrata, we understand that exceptional home bar design emerges from balancing aesthetics with functionality, style with durability, and openness with definition. The best entertaining station serves practical needs while reflecting owners’ personalities—creating spaces where mixing drinks becomes entertaining in itself, where guests naturally gather, and where ordinary evenings feel special.

Here’s to 2026—may it bring countless occasions to toast with friends and family around home bars designed with intention, built with quality, and enjoyed with gratitude. Contact Substrata to discuss creating your ultimate beverage center and entertaining station worthy of life’s best celebrations.

commercial construction cost per square foot LA

Beyond the Blueprint: How Integrated Project Delivery is Revolutionizing LA Construction

Beyond the Blueprint: How Integrated Project Delivery is Revolutionizing LA Construction 1920 1280 Cecille Maristela

The Pitfalls of Traditional, Adversarial Project Delivery

Traditional construction project delivery breeds adversarial relationships that harm everyone involved. Designers create drawings without constructor input. Contractors bid without understanding owner priorities. Subcontractors receive plans they had no role developing. When problems arise—and they always do—parties protect individual interests rather than collaborating on project solutions.

This fragmented approach creates predictable problems: change orders escalating costs 15-30% above budgets, schedule delays pushing completion months beyond projections, quality compromises when time and money run short, and litigation consuming resources that should build rather than dispute. For Los Angeles developer projects where timing and budget certainty determine financial success, traditional delivery methods introduce unacceptable risk.

Integrated Project Delivery LA represents fundamental departure from this broken model. Through shared risk/reward structures, early stakeholder involvement, and multi-party contracts aligning incentives, IPD transforms construction from adversarial contest into collaborative construction achievement. At Substrata, implementing Integrated Project Delivery has consistently delivered superior outcomes—predictable budgets, accelerated timelines, and enhanced quality that traditional methods cannot match.


What are the Integrated Project Delivery Core Principles?

Integrated Project Delivery LA

Shared Risk and Reward Structures

Integrated Project Delivery LA fundamentally differs from traditional delivery through aligned financial incentives. Rather than each party optimizing individual profit, IPD creates shared economic outcomes where team success determines individual compensation.

How IPD Financial Structures Work:

Target Cost Establishment: Early in design, the IPD team establishes target project cost through collaborative estimation. This target reflects realistic assessment rather than low-ball bids traditional competitive bidding produces. All parties commit to delivering projects at or below target costs.

Shared Contingency Pool: Rather than each contractor maintaining separate contingency, Integrated Project Delivery pools contingency funds. When projects encounter challenges, teams draw from shared pools—eliminating incentives to generate change orders that benefit individual contractors at owner expense.

Pain/Gain Sharing: If projects exceed target costs, all parties share overrun pain proportionally. If projects come in under target, all share savings. This collaborative construction mechanism aligns everyone toward common cost goals impossible under traditional commercial construction methods where contractors profit from owner problems.

Guaranteed Overhead and Reasonable Profit: Team members receive guaranteed reimbursement for overhead and reasonable profit regardless of project outcomes. This guarantee enables focus on project success rather than self-protection—participants don’t fear financial ruin if problems occur, encouraging transparency about challenges.

Early Stakeholder Involvement

Traditional delivery delays constructor and subcontractor involvement until design completes—wasting invaluable constructability knowledge during phases where input provides maximum value. Integrated Project Delivery LA brings all key stakeholders together from project inception.

IPD Team Assembly Timing:

Concept Phase: Owners, architects, general contractors, and key subcontractors (mechanical, electrical, structural) join during initial concept development. This early collaborative construction enables simultaneous consideration of design intent, constructability, cost, and schedule—impossible when parties join sequentially.

Design Phase: Throughout design development, the full IPD team meets regularly—reviewing drawings, identifying conflicts, proposing alternatives, and refining approaches. Problems caught during design cost hundreds to fix; those discovered during construction cost thousands or tens of thousands. Early involvement prevents expensive late changes.

Construction Phase: Because teams collaborated during design, construction execution proves smoother. Contractors understand design intent. Designers understand construction methodology. Owners understand trade-offs made. This alignment, established through Integrated Project Delivery, prevents misunderstandings that plague traditional projects.

Single Multi-Party Contract

Perhaps the most distinctive Integrated Project Delivery LA feature involves contractual structure. Rather than separate contracts between owner-architect and owner-contractor (traditional design-bid-build) or single contract with design-builder (design-build), IPD employs multi-party contracts binding all key participants.

Multi-Party Contract Characteristics:

Joint Liability: All parties accept joint responsibility for project outcomes. If problems arise from any source—design errors, construction defects, unforeseen conditions—the team collectively addresses issues rather than pointing fingers. This collaborative construction approach prevents the blame-shifting consuming resources on traditional projects.

Unanimous Decision-Making: Major project decisions require unanimous agreement among core team members. While potentially cumbersome, this requirement ensures all perspectives receive consideration—preventing owner-only decisions ignoring constructability or designer-only decisions ignoring cost.

Waiver of Claims: IPD contracts typically include waivers preventing parties from suing each other (except for willful misconduct). This waiver eliminates defensive behaviors protecting against litigation—enabling transparent communication about problems when they’re manageable rather than hiding issues until they become catastrophic.

Open-Book Accounting: All costs remain visible to all parties. Contractors cannot hide markups or pad estimates. Owners cannot accuse contractors of profiteering. This transparency, central to Integrated Project Delivery, builds trust impossible under traditional commercial construction methods.


Benefits for Clients: Why IPD Delivers Superior Outcomes

commercial construction cost per square foot LA

Predictable Budgets Through Collaborative Cost Management

Budget predictability represents perhaps the most compelling Integrated Project Delivery LA advantage for Los Angeles developer clients. Traditional projects regularly overrun budgets through change orders, unforeseen conditions, and design modifications. IPD’s collaborative construction approach produces markedly different outcomes.

Budget Certainty Mechanisms:

Continuous Cost Tracking: Rather than waiting for bids after design completion, IPD teams track costs throughout design. When developing space layouts, mechanical system concepts, or finish selections, teams know cost implications immediately. This real-time feedback enables informed decisions impossible under traditional commercial construction methods.

Value Engineering Integration: Traditional projects conduct value engineering after discovering budget overruns—desperate cost-cutting compromising original vision. Integrated Project Delivery performs value engineering continuously during design—optimizing value without crisis-driven compromise.

Contingency Discipline: Shared contingency pools create discipline around contingency use impossible under traditional structures where contractors benefit from contingency depletion. IPD teams conserve contingency, using it only when truly necessary—resulting in projects returning unused contingency to owners rather than consuming it entirely.

Statistical Performance: Studies show Integrated Project Delivery LA projects average 1-3% budget variance compared to 8-12% for traditional delivery. For $20 million projects, this difference represents $1.5-2.2 million—substantial savings justifying IPD’s upfront coordination investment.

Faster Timelines Through Concurrent Activities

Schedule acceleration provides another compelling IPD benefit. Traditional sequential delivery—complete design, then bid, then construct—consumes months in transitions between phases. Integrated Project Delivery overlaps activities dramatically compressing overall timelines.

Schedule Compression Strategies:

Early Release Packages: IPD teams release foundation drawings before finalizing interior details—enabling early site work starting while design continues. Traditional projects cannot start construction until complete design, wasting months that collaborative construction approaches recover.

Pre-Fabrication During Design: Knowing construction methodology during design enables pre-fabrication beginning before on-site work. MEP assemblies, bathroom pods, or facade panels fabricate off-site concurrently with site preparation—parallelizing activities that traditional commercial construction methods must sequence.

Reduced RFI Response Time: Because designers and contractors collaborate throughout, requests for information (RFIs) during construction receive immediate responses—team members understand design intent and construction challenges intimately. Traditional projects average 7-14 days per RFI response; IPD projects often resolve RFIs same-day.

Measured Results: Integrated Project Delivery projects typically complete 10-15% faster than traditional projects—for 18-month traditional projects, this represents 2-3 months acceleration. For Los Angeles developer projects where earlier occupancy means faster revenue generation, this schedule advantage provides significant financial value.

Higher Quality Through Collective Accountability

Quality often suffers under traditional delivery when budget and schedule pressures mount. Integrated Project Delivery LA’s collective accountability creates different dynamics where quality becomes shared responsibility rather than competing priority.

Quality Enhancement Mechanisms:

Design for Constructability: Constructor involvement during design ensures details are buildable—eliminating the “we’ll figure it out in the field” approach that produces quality compromises. When builders say “this detail won’t work,” designers revise immediately rather than contractors improvising inferior field solutions.

Collaborative Problem-Solving: When construction challenges arise, IPD teams solve problems collaboratively—bringing design expertise, construction experience, and owner priorities together. Solutions balance aesthetics, function, cost, and schedule rather than optimizing single variables at other dimensions’ expense.

No Incentive for Shortcuts: Traditional projects create incentives for contractors to cut corners maximizing profit. Integrated Project Delivery’s guaranteed profit plus shared savings creates opposite incentive—delivering highest quality most efficiently benefits everyone through increased shared savings.

Quality Metrics: Studies measuring punch-list items, warranty claims, and owner satisfaction show Integrated Project Delivery projects outperform traditional delivery consistently—fewer defects, faster closeout, and higher satisfaction scores validating IPD’s collaborative construction approach.


Is IPD Right for You? The Ideal Project Profile

commercial construction cost per square foot LA

Projects Where Integrated Project Delivery LA Excels

While Integrated Project Delivery offers advantages for many projects, certain characteristics make some projects particularly IPD-suitable.

Ideal IPD Project Characteristics:

Complexity: Projects with technical complexity, tight sites, or unusual requirements benefit most from collaborative construction. Simple, repetitive projects with established solutions gain less from IPD’s intensive coordination—traditional methods may prove more efficient.

Budget Sensitivity: Projects where budget certainty matters critically favor Integrated Project Delivery LA. Developers with fixed financing, owners with firm budgets, or projects where cost overruns threaten viability all benefit from IPD’s budget predictability.

Schedule Pressure: Projects with aggressive timelines or where early completion provides financial benefits align perfectly with IPD’s schedule compression capabilities. Traditional commercial construction methods’ sequential phases cannot compete with IPD’s concurrent activities.

Owner Sophistication: IPD requires owner engagement throughout design and construction—not just approval at milestones. Owners willing to participate actively rather than remaining distant benefit from collaborative decision-making Integrated Project Delivery enables.

Team Chemistry Potential: IPD succeeds when team members trust each other and communicate openly. Projects where parties have existing relationships or demonstrated collaborative capabilities prove more IPD-suitable than situations involving parties with adversarial histories.

When Traditional Delivery May Suit Better

Integrated Project Delivery isn’t universal solution—certain situations favor traditional commercial construction methods.

Traditional Delivery Considerations:

Simple, Standardized Projects: Repetitive projects like warehouse developments or retail prototypes with established details may not benefit sufficiently from IPD coordination to justify its overhead.

Competitive Bidding Requirements: Public projects or institutional owners with mandatory competitive bidding cannot easily adopt Integrated Project Delivery LA’s team selection and contracting approaches.

Established Project Teams: When owners have long-standing relationships with specific architects and contractors comfortable with traditional roles, transitioning to IPD may introduce friction outweighing benefits.

Limited Owner Availability: Owners unable or unwilling to participate actively throughout projects may find collaborative construction’s decision-making requirements burdensome rather than valuable.


Conclusion: Collaborative Construction’s Proven Promise

Integrated Project Delivery LA represents more than incremental improvement over traditional methods—it’s fundamental reconception of how construction projects can and should work. By aligning financial incentives, involving stakeholders early, and binding parties through multi-party contracts, IPD transforms adversarial relationships into collaborative construction partnerships delivering superior outcomes.

The evidence validates IPD’s promise: projects completing under budget rather than over, ahead of schedule rather than delayed, with higher quality rather than compromised, and generating satisfaction rather than disputes. For Los Angeles developer projects where budget certainty, schedule acceleration, and quality delivery determine success, Integrated Project Delivery offers compelling advantages traditional commercial construction methods cannot match.

At Substrata, our commitment to Integrated Project Delivery reflects conviction that construction industry can and must evolve beyond adversarial approaches that serve no one well. Through IPD, we’ve consistently delivered projects exceeding traditional delivery outcomes—validating collaborative construction as viable path forward for complex commercial projects.

Ready to explore Integrated Project Delivery LA for your next project? Contact Substrata to discuss whether IPD aligns with your project goals and how our collaborative construction expertise can deliver the budget certainty, schedule acceleration, and quality outcomes your development deserves.
